This website uses cookies to improve your experience. We'll assume you're ok with this, but you can opt-out if you wish. Cookie settingsACCEPT
Privacy & Cookies Policy

Privacy Overview

This website uses cookies to improve your experience while you navigate through the website. Out of these cookies, the cookies that are categorized as necessary are stored on your browser as they are essential for the working of basic functionalities...
Necessary
Always Enabled
Necessary cookies are absolutely essential for the website to function properly. This category only includes cookies that ensures basic functionalities and security features of the website. These cookies do not store any personal information.
Non-necessary
Any cookies that may not be particularly necessary for the website to function and is used specifically to collect user personal data via analytics, ads, other embedded contents are termed as non-necessary cookies. It is mandatory to procure user consent prior to running these cookies on your website.
SAVE & ACCEPT
    • Politics
    • Transport
    • Lifestyle
    • Community
    • Business
    • Crime
    • Environment
    • Health
    • Education
    • Sport
    • Harrogate
    • Ripon
    • Knaresborough
    • Boroughbridge
    • Pateley Bridge
    • Masham
  • What's On
  • Offers
  • Newsletter
  • Podcasts

Interested in advertising with us?

Advertise with us

  • News & Features
  • Your Area
  • What's On
  • Offers
  • Newsletter
  • Podcasts
  • Politics
  • Transport
  • Lifestyle
  • Community
  • Business
  • Crime
  • Environment
  • Health
  • Education
  • Sport
Advertise with us
Subscribe
  • Home
  • Latest News

We want to hear from you

Tell us your opinions and views on what we cover

Contact us
Connect with us
  • About us
  • Advertise your job
  • Correction and complaints
Download on App StoreDownload on Google Play Store
  • Terms and Conditions
  • Privacy Statement
  • Comments Participation T&Cs
Trust In Journalism

Copyright © 2020 The Stray Ferret Ltd, All Rights Reserved

Site by Show + Tell

Subscribe to trusted local news

In a time of both misinformation and too much information, quality journalism is more crucial than ever. By subscribing, you can help us get the story right.

  • Subscription costs less than £1 a week with an annual plan.

Already a subscriber? Log in here.

14

Mar 2024

Last Updated: 14/03/2024

Roadworks due as Northern Powergrid begins £5.5m scheme in Harrogate

by Lauren Ryan

| 14 Mar, 2024
Comment

0

npg-pic-1
Steve Crawford (left) Sharon Incerti and their colleague with the planned route

Northern Powergrid will begin a £5.5m scheme to make the electricity supply in the Harrogate area more reliable next week.

The company, which manages the electricity network for 3.9 million people, has said the upgrade will "improve the resilience and reliability of the vital local electricity network”.

But it will cause disruption to motorists on some of Harrogate's busiest roads, including Ripon Road, Clarence Drive and Jenny Field Drive, where the work will start.

Upgraded cabling will be installed in 22 areas of Harrogate. Work will begin on Monday, March 18 and is due to end in September.

It will require having open excavated trenches in the roads. The trenches will be protected by barriers and some locations will have two-way traffic lights.

Northern Powergrid revealed the plans at a drop-in session on Tuesday night at Harrogate's Crown Hotel, which businesses were invited to attend.

The Stray Ferret, which attended the meeting, was told Northern Powergrid and North Yorkshire Council have been in talks about the work for over a year in consultation with local councillors, Harrogate Business Improvement District and Harrogate District Chamber of Commerce.

Northern Powergrid operates to five-year plans and is currently working to its 2023-2028 plan, which includes upgrading its network. Once its plans are approved by a regulator, the company can receive funding from a fund, which is sourced from a percentage of bill payers' money.

A similar scheme to upgrade York's network, costing £1.5m, is currently underway.

Northern Powergrid five million pound investment route



A spokesperson for Northern Powergrid told the Stray Ferret that the upgrades were essential. They said:

"These upgrades are what Harrogate needs to improve reliability, The works are being done to future proof the town. We Invest ahead of need, we don’t wait until there is no power we are doing it before it is needed."


Northern Powergrid said the increasing number of electric vehicles, housing and hospitality venues made it essential to act now.

It added that businesses and houses now required a range of electric outlets and an increasing number of venues including hotels and pubs were changing from gas to electric to meet net zero goals, putting more demand on the power supply.

Steve Crawford, project manager said:

"With the decarbonisation agenda there is a real uptake in electric power. All of this technology requires electric power reinforcing to meet this increased need.
"This work will create capacity for new developments and low carbon technology connections to support the town’s economic growth. Now is the right time for Harrogate the upgrades are what the town needs right now.
"It allows future services to progress but we can’t tell how long these reinforcements will last. We wouldn’t spend more than the area needs but we can’t afford to wait until it is broken.”


When and Where


Residents will receive letters up to two weeks in advance of work beginning, the company said. The project will start next week on Jenny Field Drive and is due to end at Majestic Court in September.

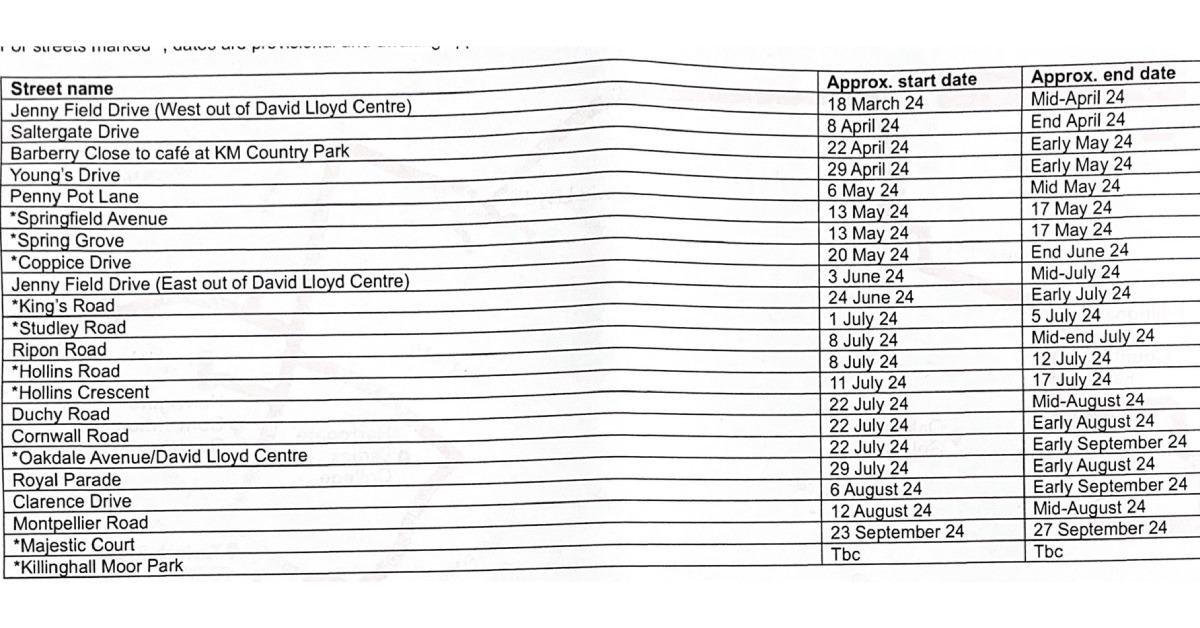

Full list of Northern Powergrid times and dates for the investment works


The impact


Work is expected to take place from 8am-5pm but Northern Powergrid have purposely avoided the Crescent Road, Ripon Road and King’s Road junction to reduce disruption.

It said access for residents, businesses and emergency vehicles will be maintained disruption would be minimised by, for example, avoiding work near Harrogate Ladies' College during term time. Public transport will continue.

The last major Northern Powergrid work in the area took place almost eight years ago near David Lloyd, where the company's substation is located. It said the David Lloyd to Penny Pot Lane section will take the longest time to upgrade due to there being a single circuit along the route.



Mr Crawford said:

“People won’t notice a difference, we hope the upgrades will be seamless, which for us is a good thing if people cannot tell. People don’t notice power until it has gone so we are working behind the scenes and there should be no interruptions to power."


Sharon Incerti, project manager said;

"No one is expected to be off supply and there are no planned outages for the work to go ahead. There can always be faults but they are not expected. This is a really positive scheme for Harrogate.
"It will be some short term disruption to meet Harrogate's wider and ever-changing needs."


To keep up to date check www.onenetwork.com and contact generalenquiries@northernpowergrid.com for any further information.




Read more:



  • 5 things to do in and around Harrogate this weekend

  • Council tree expert 'not in a position to support' Harrogate Spring Water
